ALLO has worked hand in hand with residents and the town of Erie to ensure all construction questions and concerns have been resolved as quickly and as safely as possible. We will continue to keep residents informed of ALLO happenings through direct mail and our customer email, Stay in the Know.

Weekly Update – 12/16/24

12/18/24 Update: Crews will be setting up structures and completing restoration in PON 1 and PON 2.
J&R will be blowing string in PON 1 and PON 2.

Two drills are running in PON 13 today.

Weekly Update – 12/09/24

12/10/24 Update: PON 01 and PON 02 both now have boring 100% done. Again, no drilling today as the crews complete restoration in PON 01 and PON 02.

No Drilling will be taking place today (Monday). Crews will be setting up structures and completing restoration in PON 1 and PON 2. J&R will be blowing string in PON 1 and PON 2.

Weekly Update – 12/02/24

12/05/24 Update: In PON 01 boring is 98% complete and PON 02 is 85% complete. Additionally in PON 04 splicing is expected to start 01/01/25

12/04/24 Update: Drilling is taking place in PON 01 and PON 02. In PON 01 boring is 98% complete and PON 02 is 80% complete.

12/03/24 Update: There will be no drilling today. J&R will be blowing string in PON 1 and PON 2.

No drilling today. Crews will be setting up structures in PON 1 and PON 2 to get the PONs finished up.

Weekly Update – 11/25/24

Happy Thanksgiving week! Drilling will not be taking place on Wednesday, Thursday or Friday.

Weekly Update – 11/18/24

11/22/24 Update: There will be no drilling today.

11/20/24 Update: The team will be working in ONLY PON 02 today.

11/19/24 Update: J&R Drilling will be working in PON 02 and PON 04 today.

Work remains ongoing and J&R Drilling is working in PON 02. For specific construction locations, check out the maps below.

Weekly Update – 11/11/24

11/12/24 Update: J&R Drilling will be working in PON 01 and PON 02 today.

Work remains ongoing and J&R Drilling is working in PON 02. For specific construction locations, check out the maps below.

Weekly Update – 11/04/24

11/08/24 Update: No Drilling is taking place today. You can see maps below to identify where drilling took place over the last few days.

11/06/24 Update: J&R Drilling will be working back in ONLY PON 02 today.

11/05/24 Update: J&R Drilling will be working in both PON 01 and PON 02 today. See maps below for more specific locations.

Work remains ongoing. J&R Drilling is working in PON 02 and cable pulling teams are working in PON 04.

Weekly Update – 10/28/24

10/30/24 Update: J&R Drilling work continues in PON 02 and is about 33% complete. See maps below for work areas with bores. Construction signboards are still placed in PON 02 at the intersection of Mercedes Road and Morgan Circle South. Cable pulling teams are in PON 04 and splicing is expected by 1/1/25.

Work remains ongoing. J&R Drilling is currently working in PON 02. ALLOs aerial team will be working along the west side of PON 4 along 119th St.

Weekly Update – 10/21/24

10/24/24 Update: J&R Drilling will be working heavy in the area between Morgan Cir N and Morgan Cir S. See maps below for more specific location information.

Work remains ongoing. J&R Drilling is currently working in PON 02. See maps below to see where the team is working on a daily basis.

Weekly Update – 10/14/24

10/15/24 Update: Drilling has resumed in PON 02. See maps below for drilling locations.

No drilling is taking place on Monday as a result of the holiday. The team is setting structures only.

Weekly Update – 10/07/24

10/09/24 Update: J&R Drilling has began boring in PON 02. See maps below.

Work is ongoing in PON 01. J&R Drilling will likely move into PON 02 this week.

Weekly Update – 9/30/24

10/01/24 Update: Backbone is in PON 04 pulling fiber.

Work is ongoing and J&R Drilling remains working in PON 01. Last week they called in locates for PON 02 and are waiting for those before moving one of the two drills into PON 02.

Weekly Update – 9/23/24

9/25/24 Update: J&R has begun calling in locates in the south area of PON 2. Once the locates clear, one drill will move into PON 2.

Work is ongoing and J&R Drilling is currently performing underground bores in PON 01. Additionally the team is preparing to begin work in PON 02.

Weekly Update – 9/16/24

9/19/24 Update: Work is ongoing. J&R Drilling is currently working in PON 01. The ALLO fiber testing team is not testing in PON 05 today.

9/18/24 Update: Work is ongoing. J&R Drilling is currently working in PON 01 while ALLOs fiber testing team remains testing in PON 05.

9/16/24 Update: Drilling work remains ongoing in PON 01. Additionally, ALLO construction sign boards have been placed accordingly:
PON 1 – C.W .Bixler Blvd & East County Ln Rd.
PON 1 – Delechant Dr & County Ln Rd
PON 2 – Mercedes Rd & Morgan Cir S.

Weekly Update – 9/09/24

9/13/24 Update: Door-to-door notifications have been completed for 100% of PON 01. In PON 02, flags have been placed around mailboxes and areas of interest. In addition, the Morgan Hill HOA letter has been sent and door-to-door has initiated notifications on the south end of PON 02.

9/11/24 Update: PON 05 has been released. Final work is pending County Line Rd moratorium.

9/10/24 Update: PONS 01 – 05 have been completed and tested. However, there are a few addresses that are pending release.

Testing is currently underway in PON 05 and the PON is expected to be released Friday September 13th.

Weekly Update – 9/02/24

9/06/24 Update: After Tuesday’s meeting, the Town discussed and decided to grant Allo with the following change:
The Town will allow ALLO to extend working hours from 7:00 a.m. to 4:00 p.m. only if no traffic control is required in vehicular travel lanes. However, if work conditions include pedestrian/sidewalk closures that may consist of “walking routes” to schools or school zones, work may only happen between 9:00 a.m. and 2:30 p.m. and is subject to coordination with Town staff.

9/05/24 Update: Work is ongoing and J&R Drilling is still working in PON 01. Currently they are working off the East side of Lombardi St just North of Kempton Ct and North and South of Kanemoto Ln. Additionally, the crew is working just off the West side of Washburn St.

9/04/24 Update: The ALLO Fiber Testing team is currently testing in PON 05

Work is ongoing in Erie. PON 9 is live and ready to begin installing.

Weekly Update – 8/26/24

8/30/24 Update: All boring is limited to noon today and no boring will take place on Monday. All open holes are secured and safe going into the weekend.

8/29/24 Update: The ALLO Fiber Aerial Team is currently working in PON 08.

8/28/24 Update: The ALLO Fiber pulling team is working in PON 05 & PON 09. Additionally, PON 09 is live and ready for installs.

8/27/24 Update: The ALLO Fiber pulling team is performing repulls in PON 09.

Work is ongoing in PON 01. A request to relocate the PON cabinet in PON 01 was submitted and a new location is being investigated. Cable pulling is complete in PON 09. A team will be working in PON 05 to pull in the feeder.

Weekly Update – 8/19/24

8/22/24 Update: The J&R cable pulling team has completed pulling fiber into MSTs in PON 05.

8/21/24 Update: Door-to-Door notifications are now 75% complete in PON 01. Morgan Hill HOA letters have been sent to PON 02 and the cabinet/vault was installed at CR 10.5 and Fletcher Drive.

8/20/24 Update: The Town Park walkout with Luke Fisher was completed yesterday at 9:00 AM.

Bi-weekly town hall meetings have moved to a once-a-month schedule. Work is ongoing in PON 01. HOA letters have been sent and door-to-door notifications are 55% complete. Construction signboards in PON 01 have been moved to the intersections of C.W. Bixler Boulevard and East County Line Road and Delechant Drive and County Line Road. In PON 02, construction signboards were moved to the intersection of Mercedes Road and Morgan Circle South.

Weekly Update – 8/12/24

Work in PON 01 is underway as permits were received and locate tickets are in progress. As mentioned last week, construction signboards and constructions flags have been placed in PON 01. Construction flags have also been placed in PON 02 in anticipation of construction beginning soon. Two drills will be working this week, with one in PON 01 and another in PON 04. An additional request has been placed for a third drill to work in PON 01 and move into PON 02.

Weekly Update – 8/5/24

8/8/24 Update: Permits have been received and locates are in progress for PON 01. ALLO representatives will be at the Erie Village virtual HOA meeting on August 14th to answer questions on the construction process. Flags have been placed around mailboxes and areas of interest in PON 02.

8/6/24 Update: Two additional ALLO construction signboards have been relocated to the intersections of Washburn Street and White Lane, and Delechant Drive and Farmer Place. In addition, construction lawn flags were placed near neighborhood mailboxes on Washburn Street, St. John Street, and Delechant Drive.

Work will begin soon in PON 01. Door-to-door notifications are 40% complete and HOA letters have been sent. Construction sign boards have been relocated to the intersections of Lombardi Street and Meadowlark Drive, and C W Bixler Boulevard and Allen Avenue. Underground construction in PON 05 will start at 89 Briggs and working south.

Weekly Update – 7/29/24

Work will begin in PON 01 this week. Door-to-door notifications are 40% complete for the PON and HOA letters have been sent. Construction sign boards have been placed at the intersection of Lombardi Street and Meadowlark Drive and West Bixler Boulevard and Allen Avenue.

Weekly Update – 7/22/24

A permit release for PON 01 is pending with the Town of Erie, as is a permit to close out PON 03. Work in PON 12 by the ALLO splice team is 99% complete and service is live, with a permit to close out pending approval with the Town of Erie. Maps are available below showing where bore work is happening in PON 04. ALLO cable pullers are in Erie working in PON 09, while J&R is pulling MST’s into structures and SNAM Aerial will re-engage aerial work this week in PON 05.

Weekly Update – 7/15/24

Boring and structures will take place in PON 10 this week as we work to complete the North Feeder route (see maps below). PON 03 is now complete and active for service. The J&R cable pulling team has completed their work in POIN 09, while the ALLO splice team has completed their work in PON 12, pending testing. The permit release for PON 01 is pending with the Town of Erie.

Weekly Update – 7/8/24

The Erie Parkway Crossing in PON 09 is planned for Tuesday, July 9th. Two J&R drills are working in PON 04. In addition, a few things are being finished in PON 05.

Weekly Update – 7/1/24

Pending town approval, the permits will be closed out in PON 17. ALLO Aerial team is splicing north of the RTD tracks in PON 03 while the ALLO Splice team works in PON 12. J&R cable and structure teams are working in PON 09, while two J&R drills continue work in PON 04 between Stockton Drive and Conrad Drive. The Erie Parkway Crossing in PON 09 is planned for July 9th.

Weekly Update – 6/24/24

The ALLO aerial team is working the RTD crossings on 109th and 119th streets in PON 03. The ALLO cable pulling team is working in PON 12 and the J&R cable pulling team is working in PON 09. Our partners at J&R have two drills performing bores in PON 04. Maps showing exact locations are below.

Weekly Update – 6/17/24

6/18/24 Update: J&R Drilling will continue PON 04 bore work with two drills active. Maps with specific locations can be viewed below. Pothole repair will get underway in PON 12 and PON 09. No bore work will take place on 6/19 due to the town holiday.

Crews from J&R Drilling are working in PON 04 near Meller Street, and near Palmer Lane. Crews are also repairing potholes along Arapahoe Road.

Weekly Update – 6/10/24

Schofield Farm in PON 09 is spliced, light-tested, and ready for service. Installers will be working in the area this week. Boring continues in PON 04 beginning at the intersection of 1902 Gordan Drive and Brennan Street. Additional boring working continues in PON 09 on Leyner Drive.

Weekly Update – 6/3/24

Two drills will be working on underground bores this week. One drill will be completing the final RTD bore on the west side on PON 03 at 109th Street on Tuesday, 6/4/24. The other drill will be working in PON 04 along Erie Parkway on 6/3/24. Remaining bores in PON 05 to the cabinet location will be completed this week.

Weekly Update – 5/27/24

Construction notice signs have been placed in PON 04 prior to the restart of construction. RTD crossings in PON 05 and PON 03 are scheduled for May 29th & 30th. The Briggs crossing will be first on Wednesday. After the Briggs crossing is complete, the drill will move to PON 03 to complete the final two RTD crossings. Traffic control plans have been submitted for review.

Weekly Update – 5/13/24

5/16/24 Update: J&R Drilling will continue PON 05 bore work with the first drill starting at 115 Huntley Creek Court, and the second drill starting at 415 Holbrook Street. Boring in PON 05 will be complete by end of day Friday.

5/15/24 Update: J&R Drilling will continue PON 05 bore work with the first drill starting at 119 Huntley Ct., and the second drill starting at 459 Kattell St. Boring in PON 05 will be complete by end of day Friday.

SNAM aerial is not working as they await underground construction completion in PON 05. J&R bore work is continuing on Maxwell Circle and between homes throughout the Erie Commons neighborhood in PON 05. Construction notice signs are placed at both entrances to Erie Commons. PON 17 restoration of street cores is ongoing.

Weekly Update – 5/6/24

5/8/24 Update: J&R Drilling will begin bore work on Maxwell Ave and Briggs in Erie Commons (PON 05). Construction notice signs are in place at both entrances to Erie Commons. Final restoration of street cores in PON 17 will begin today on the north side off of 111th Street.

SNAM aerial work continues PON 05. J&R and ALLO in-house crews are not working yet as we await cleared tickets for locates that were called in for Maxwell Ave in Erie Commons (PON 05). Construction notice signs have been placed at both entrances to Erie Commons.

Weekly Update – 4/29/24

J&R Drilling and inhouse ALLO crews are not working yet as we await additional permits. A bore crew will be working all three RTD rail crossing bores in PON 03 as permits become available. ALLO crew locations to be provided when additional permits are released and crews can restart work in PONs 03, 09, and 12.

Where are crews this week?

Erie crew locations
Crew Name Location or Intersection PON Type of Work Notes
ALLO Testing Team Not working Fiber Testing
ALLO Splice Team Not Working Fiber Splicing
ALLO Cable Pulling Team Working in market PON 04 Fiber Installation
ALLO Aerial Team Working on aerial to underground redline changes PON 04 Fiber Installation
J&R Cable Pulling Team Working in market PON 01 & PON 02 Fiber Installation
J&R Drilling Two drills working PON 13 Underground construction
Backbone Not Working Cable pulling

Boring Locations

Our construction page and blog are great resources for learning more about the entire fiber construction process.

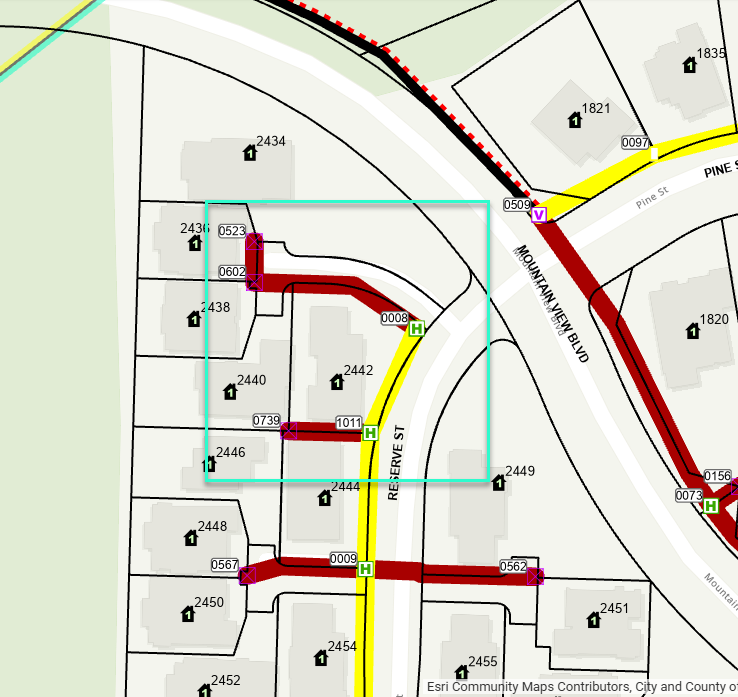

The associated map shows where J&R Drilling will be working on December 18th, 2024. The crew is currently working in PON 13 just West and behind the house line along Grenville Cir.

The associated map shows where J&R Drilling will be working on December 18th, 2024. The crew is currently working in PON 13 between Cabot Dr and Drake Ave.

Current Bore Locations

The map to the left shows where a partner crew from J&R Drilling is currently performing underground construction in PON 04. The crew is performing bore work along Erie Parkway. Final bore work in PON 05 will also be performed this week. Construction notice signs are posted at both entrances to Erie Commons. The areas highlighted in yellow are where you can expect to see the bore crews.

Our construction page and blog are great resources for learning more about the entire fiber construction process.

Overall Construction Progress

When ALLO builds our fiber network in a city, we divide that city into PONs. PONs (or passive optical networks) are like the ALLO map of your community, zoned according to geographic location, easement or right-of-way access, construction costs, access permitting, and existing facilities. Read more about PONs and fiber installation.

The Town of Erie was split into 19 different PONs, each of them numbered. The adjacent map shows each of the PONs and their associated PON number.

Check out the latest overall progress map for Erie and search your address to see what phase of construction your home is in.

Construction Map

Map of Erie construction and PON numbers.

FAQs

Yes, ALLO will continue to sell, provide services, offer customer service, be involved in Erie events, and be an active community member. The ALLO store will remain open to customers.

We’re glad you’re part of the Fiber Fam! We will continue to keep residents informed when there is progress to their address, using direct mail, email, text, and calls.

If you want ALLO service in your neighborhood, we encourage you to Sign Up for ALLO today! And don’t forget to tell your neighbors to do the same. We’ll keep you in the know regarding progress updates in your area.

Part of ALLO’s underground construction process involves boring a hole in an alley, street, or sidewalk. The result is a street core – or hole in the street – that needs to be filled or restored. ALLO restores the street cores with concrete or asphalt, whichever matches the original construction material.
